A utility crossing underway on a road shoulder: conduit staged on the verge, an entry pit in red clay, crew in hi-vis.

Conway, SC · Directional drilling · Auger boring · Microtunneling

Trenchless utility contractors who go under the road, not through it.

Trenchmark Underground Co. installs water, sewer, gas, power and fiber beneath highways, railroads and rivers across the Carolinas - bored, cased, tested and handed over with an as-built. The surface above the crossing is left the way we found it.

  • Send plans, get a number back in five business days
  • Bonded, insured and prequalified with SCDOT & NCDOT
  • 24 years underground in the Carolinas
  • 24 yearsUnderground in the Carolinas
  • 1.6M ftOf pipe and conduit installed
  • 96 inLargest finished diameter
  • 0.71 EMRExperience modification rate

01 - Capabilities

Four ways under, and the honest limits of each

The method is chosen by the ground, the diameter and what is sitting on top - not by what happens to be on the yard. Here is the range each of our machines actually covers.

02 - What we install

Every color on the locate map

Before anyone digs, a locate crew sprays the ground in the APWA color code. We install under most of it - and we work around the rest without hitting it.

  • Blue

    Potable water

    Distribution main and transmission, ductile iron through fusible PVC and HDPE.

  • Green

    Sewer & storm drainage

    Gravity sanitary, force main, outfalls and storm crossings on grade.

  • Yellow

    Gas & petroleum

    Distribution and transmission for gas utilities, to the operator’s own procedure.

  • Red

    Electric power

    Duct bank and conduit for distribution, substation feeds and street lighting.

  • Orange

    Communications & fiber

    Conduit and innerduct for carriers, co-ops and municipal broadband builds.

  • Purple

    Reclaimed water & irrigation

    Reuse main and irrigation supply, kept clearly separated from potable.

Pink marks temporary survey control and white marks the excavation itself. In South Carolina the law is three full working days’ notice to SC811 before you break ground, and we pothole every crossing we cannot see regardless of what the paint says.

03 - Who we work for

Four customers who want four different things

A DOT contract officer and a superintendent standing in a muddy hole are not the same buyer. We answer to both, and we know which one needs the paperwork first.

  • General contractors

    You have a crossing inside a bigger job and a schedule that cannot move. We price from your plans, mobilise inside your window, and hand you a signed as-built for the closeout package.

  • Municipalities & utility districts

    Public bid, public money, and a street full of residents. We work to your standard specification, hold the pre-construction meeting, and keep the road open.

  • Investor-owned utilities

    Gas, power, water and telecom operators with their own construction procedures and their own contractor safety program. We qualify to yours before the first bore.

  • State DOT & rail carriers

    Encroachment permits, flagging, track protection and casing built to the carrier standard. We hold the prequalification and carry the limits these agencies require.

04 - Safety

The number that decides whether we are allowed to bid

On this kind of work safety is not a slogan on a truck door, it is a rating that gets checked before a bid is opened. Ours is below one, and we would rather show you why.

  • 0.71EMRThree-year experience modification rate
  • 1.9TRIRTotal recordable incident rate
  • 100%OSHA 30Of supervisors hold the 30-hour card
  • 412kHoursWorked since the last lost-time incident

Read how the safety program actually runs

05 - Recent work

Crossings we have already made

Owner, method, diameter and length - the four things that make a job a useful reference rather than a nice photograph.

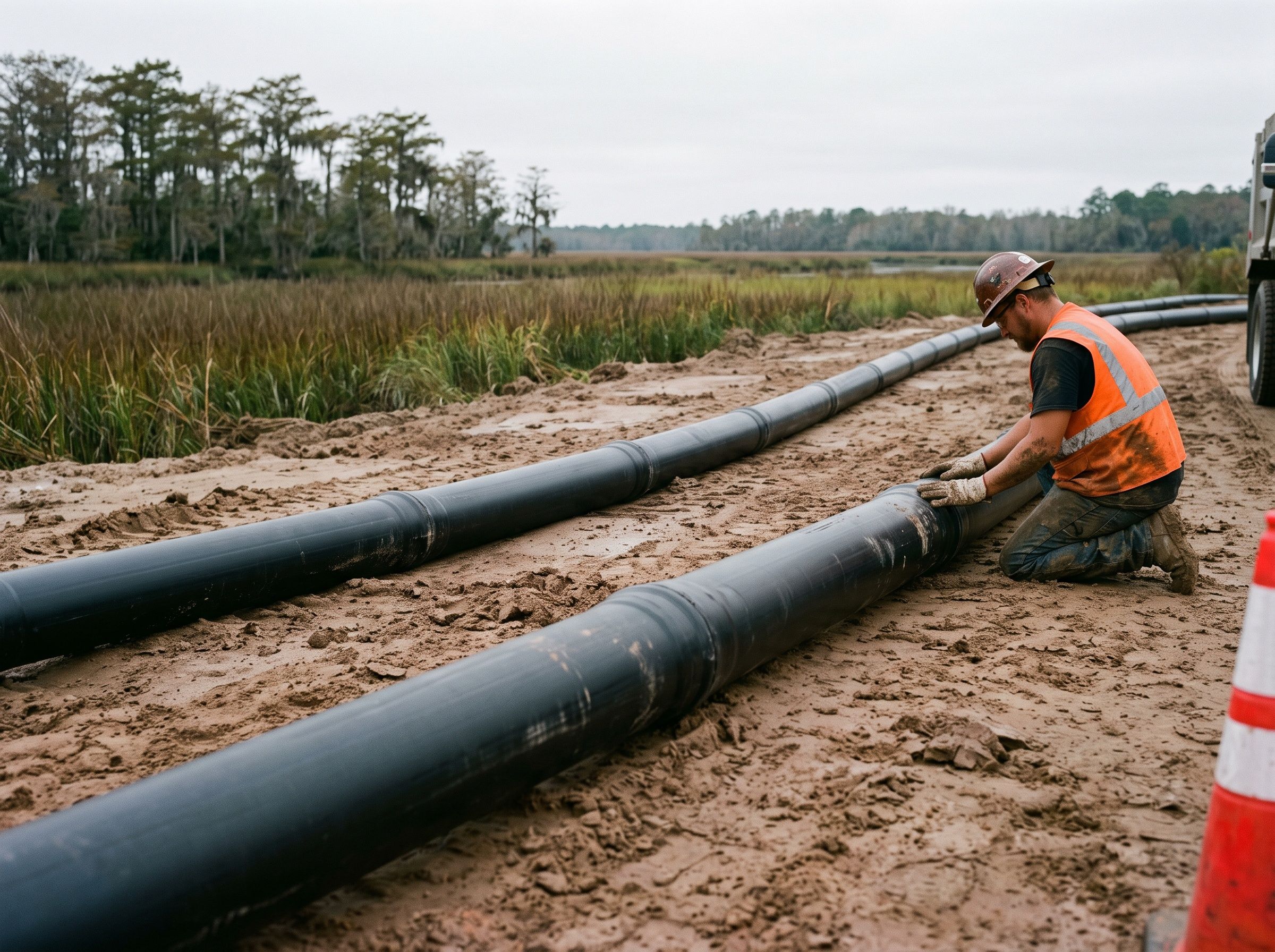

  • Horizontal Directional Drilling at Waccamaw River force main crossing, Horry County, SC

    Waccamaw River force main crossing

    Owner
    Regional water & sewer authority
    Location
    Horry County, SC
    Method
    Horizontal Directional Drilling
    Size
    24 in HDPE
    Length
    1,850 ft

    A single shot under the river and both floodplains, kept 38 ft below the channel bottom with no in-water work and no disturbance to the wetland on either bank.

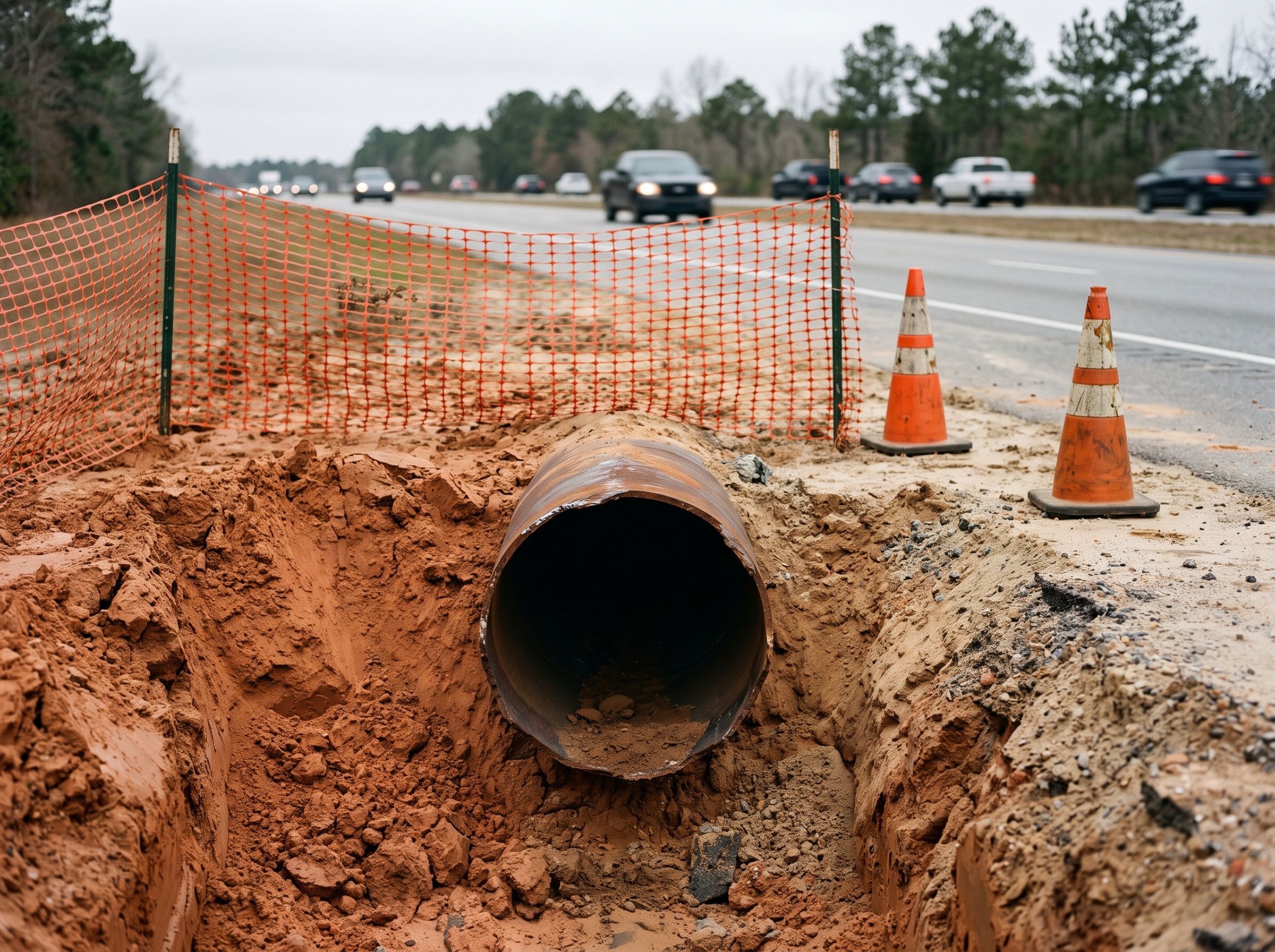

  • Auger Boring at US-501 casing for water transmission, Conway, SC

    US-501 casing for water transmission

    Owner
    Municipal water utility
    Location
    Conway, SC
    Method
    Auger Boring
    Size
    48 in steel casing
    Length
    320 ft

    Jacked under five lanes and the median without a single lane closure, on an SCDOT encroachment permit, with the carrier pipe installed on spacers the same week.

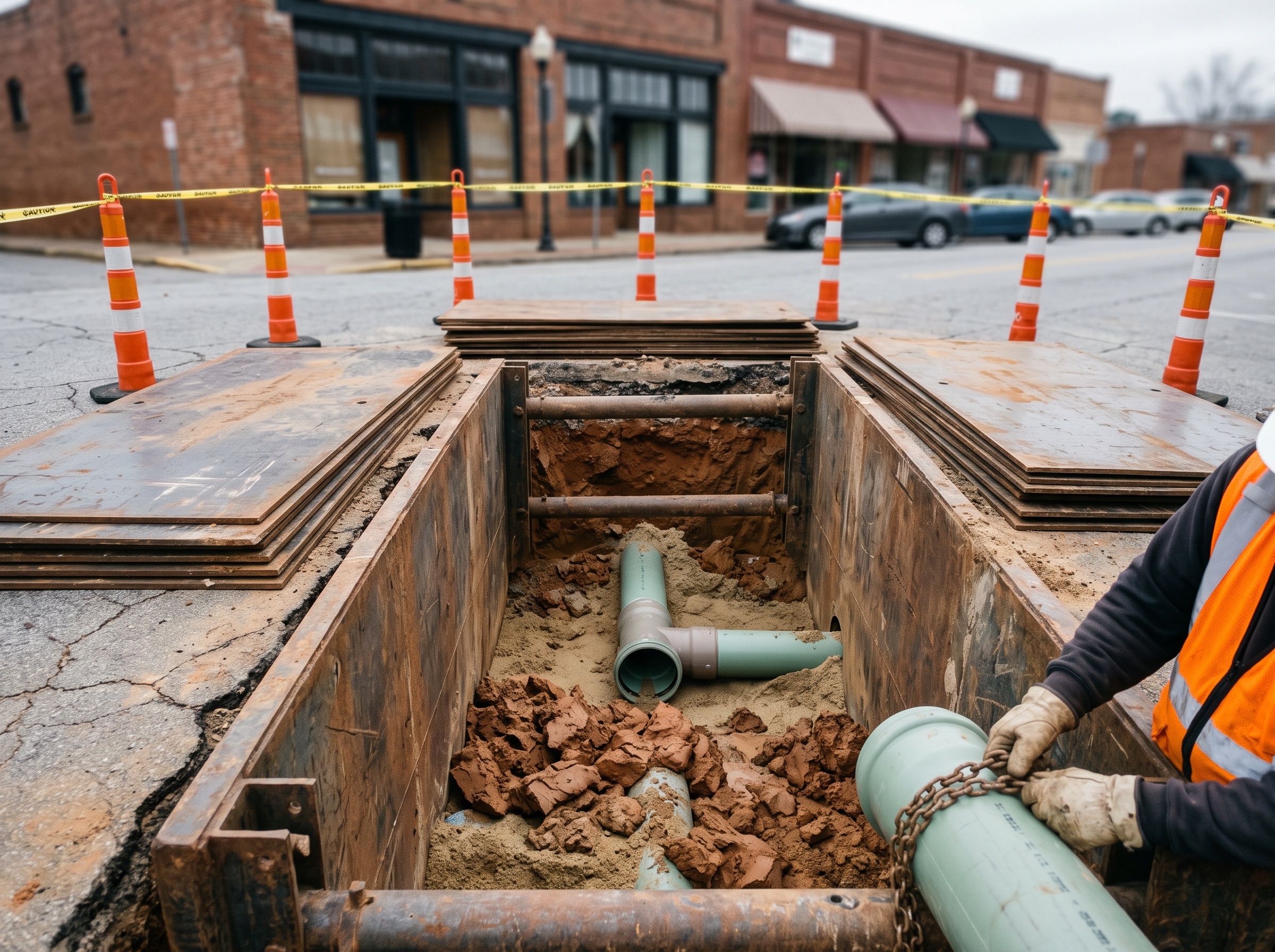

  • Pilot Tube Guided Bore at Downtown gravity sewer replacement, Georgetown, SC

    Downtown gravity sewer replacement

    Owner
    City public works department
    Location
    Georgetown, SC
    Method
    Pilot Tube Guided Bore
    Size
    15 in PVC
    Length
    3 drives, 940 ft total

    Replaced a failing clay line under a historic commercial block from three small pits, holding the invert to a half inch so the businesses above stayed open through the job.

See the full project list

06 - How a bore goes

From the locate call to the as-built

Most of the risk on a crossing is spent before the rig starts turning. This is the order we do it in, on every job, whether it is 200 feet or 2,000.

  1. Locates and potholing

    We call 811, verify the marks against the record drawings, and soft-dig every crossing we cannot see before a rig moves.

  2. Survey and bore plan

    The alignment gets designed, not guessed: entry and exit points, depth of cover, radius of curvature, and where the pits go.

  3. Pits, shoring and setup

    Engineered shoring, dewatering if the water table calls for it, and containment sized for the spoil the drive will make.

  4. The drive

    Pilot bore, ream and pull back, or jack the casing forward. Pitch, depth and grade recorded through the whole shot.

  5. Test, restore, as-built

    Pressure or deflection test, surface put back the way we found it, and a signed as-built in your hands for the closeout package.

Send us the plans.

Sheet, station and a soil report if you have one. We will tell you which method fits, what it costs, and - if it is the wrong job for us - who you should be calling instead.

Working across South Carolina · Coastal Plain · Midlands · Upstate · Eastern North Carolina · Coastal Georgia.
